Planning — roadmaps, generated tickets & timeline
Planning at /planning turns a description of the work into tickets. You describe the
outcome, Ouroboros drafts the tickets with their sizes and dependencies, you review them, and
then you push them to your tracker, where the loop can pick them up. The same screen holds
your workspace's roadmap: the epics you are working towards, laid out by month.
The screen has four cards:
- Generate tickets — describe the work, draft tickets, review them and push them.
- Tracker sync — each connected tracker, how it syncs (two-way sync, read sync, not syncing or not connected) and how many issues it holds.
- Backlog health — how much of the backlog is Sized, Blocked or Stale > 30d.
- Roadmap — the timeline of epics; see The roadmap.
Drafting tickets
Drafting is open to owners, admins and members; a viewer can read the plan but not draft.
- In Describe the outcome, not the tasks, write what you want to be true when the work is done.
- Open Structured outline (optional) and list the tickets: one ticket per top-level
bullet, with indented lines becoming its body. See Dependencies for how
to wire tickets together, and add a workflow in brackets —
[docs-loop]— to suggest one. - Choose the tracker the tickets are for. GitHub Issues is the tracker you can draft for today. Jira and Linear say why they cannot be chosen — not connected, or not available in this build.
- Optionally choose a Milestone: No milestone, one the tracker already has, or New milestone… with a name. A new milestone is created in the tracker when you push.
- Leave Auto-size with estimator on to size every draft as it is created. Turn on Queue XS/S tickets immediately to send the smallest tickets to the queue as soon as they are pushed — once the backlog has mirrored and sized them; anything not ready yet is reported rather than queued.
- Choose Draft tickets ⟳.
Today Ouroboros drafts from the outline: each bullet becomes one ticket. A description with no outline becomes a single ticket, and the drafts carry a note suggesting you add an outline to split it. Drafting tickets from the description alone is not available yet.
The address changes to /planning?batch=…, so you can come back to the same batch, or share
it, later.
Reviewing the drafts

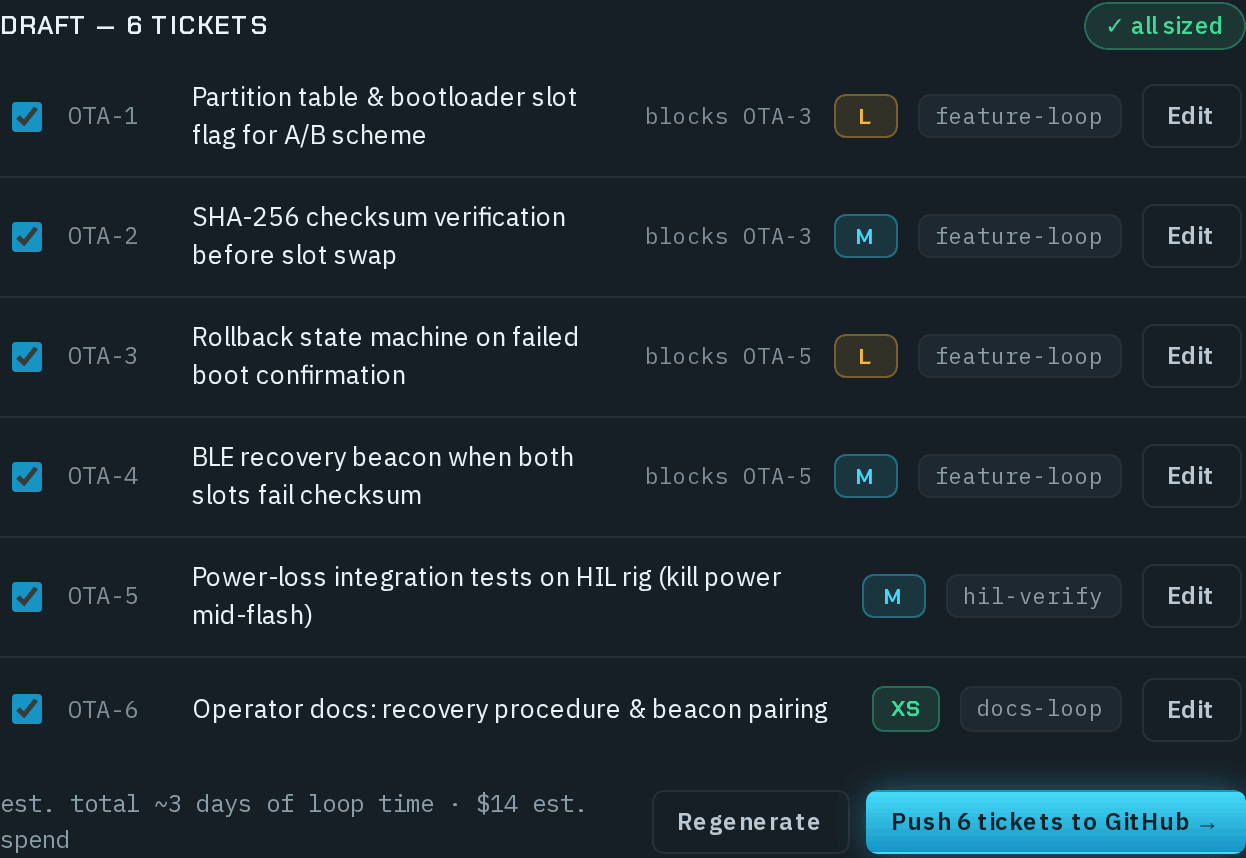

The batch is listed under Draft — N tickets. Each row shows:
- the ticket's key (
OTA-1) and title; - what it blocks — blocks OTA-3;
- its size, XS to XL, or sizing… while the estimator works — the same sizes as on Issues. Sizing runs in a shared queue, so a draft can wait behind other work; the chip fills in when its answer lands, and the head of the list shows ✓ all sized when every draft is done;
- the suggested workflow;
- Edit, to change its title and body before you push. Save keeps the change.
Below the list, est. total adds up the loop time and the estimated spend of the ticked drafts.
Choose what goes to the tracker with the tick box on each row. Every draft starts ticked; untick the ones you do not want. There is no separate accept or reject — a ticked draft is pushed, an unticked one is not. Your ticks and edits are saved as you make them.
Regenerate drafts the batch again from the same description and outline, replacing every draft that has not been pushed. Your ticks are kept; edits to unpushed drafts are not. To change the outline itself, edit it and choose Draft tickets ⟳ for a new batch.
Drafts the Build Analyzer wrote from its findings open here too. They have no description to regenerate from, so Regenerate is greyed out for them; edit or untick them instead.
Dependencies
You wire dependencies in the outline, before drafting:
blocks: OTA-3on a bullet — this ticket must be done beforeOTA-3.after: OTA-1— this ticket waits forOTA-1.- A numbered list is a sequence: each ticket depends on the one before it. Use
-bullets for work that can run in parallel.
Each draft shows the tickets it blocks. Dependencies cannot be edited after drafting; change the outline and draft a new batch. If the outline's dependencies form a cycle, the batch is still drafted, with a note saying so, but it cannot be pushed until you remove one of the links. An annotation naming a key that is not in the batch is ignored, and the note lists it.
Pushing tickets to the tracker
Choose Push N tickets to GitHub → to write every ticked draft to the tracker. Only owners and admins can push.
There is no confirmation: one press creates real issues in GitHub that everyone with access to the repository can see. Ouroboros never deletes or closes an issue it created, so undoing a push is done by hand in GitHub. Review the ticked drafts, their titles, bodies and milestone before you press it.
What is written
For a GitHub tracker, the push writes to the first repository enabled for that tracker:
- One issue per ticked draft, in dependency order — blockers first. The issue has the draft's title, its body followed by a Filed by Ouroboros footer and a hidden marker linking it to its draft, and the milestone you chose. No labels are added.
- The milestone, created if the tracker does not have it yet.
- Dependencies, as GitHub's own blocked by links. On a GitHub server without them, the link is recorded as a hidden marker in the issue's body instead. A dependency on a draft you did not tick is not sent.
- The epic, when the batch is filed under one: a parent tracking issue for the epic is created the first time, and each new issue is added to it as a sub-issue.
While the push runs, the button reads Pushing… and each row changes to pushing…, then pushed ✓ #612 — a link to the new issue — or failed with the reason. The result is summed up below the list, for example Pushed 6 tickets to GitHub.
Pushing twice is safe
- A draft that has been pushed is never pushed again, and it can no longer be edited here — Pushed — edit it in the tracker. Later edits in Ouroboros never overwrite the issue.
- If some drafts did not land, the button becomes Resume push, which retries only those. Before it creates an issue, Ouroboros looks for one carrying the draft's marker, so an issue that was created but not recorded is found rather than duplicated.
- If GitHub is rate limiting, the push stops and tells you the time, in UTC, after which to choose Resume push.
- A draft whose blocker did not land waits — waiting on OTA-3, which has not been pushed — and goes with Resume push once its blocker is in.
Undoing a push
Ouroboros keeps the drafts it pushed marked as pushed, and it has no unpush. To undo:
- In GitHub, close or delete the issues the push created — each one ends with Filed by Ouroboros, and the pushed ✓ #… links on the drafts take you to them.
- Remove the milestone and the epic's parent tracking issue if the push created them and you no longer want them.
- To file the work again, draft a new batch; the old one stays pushed.

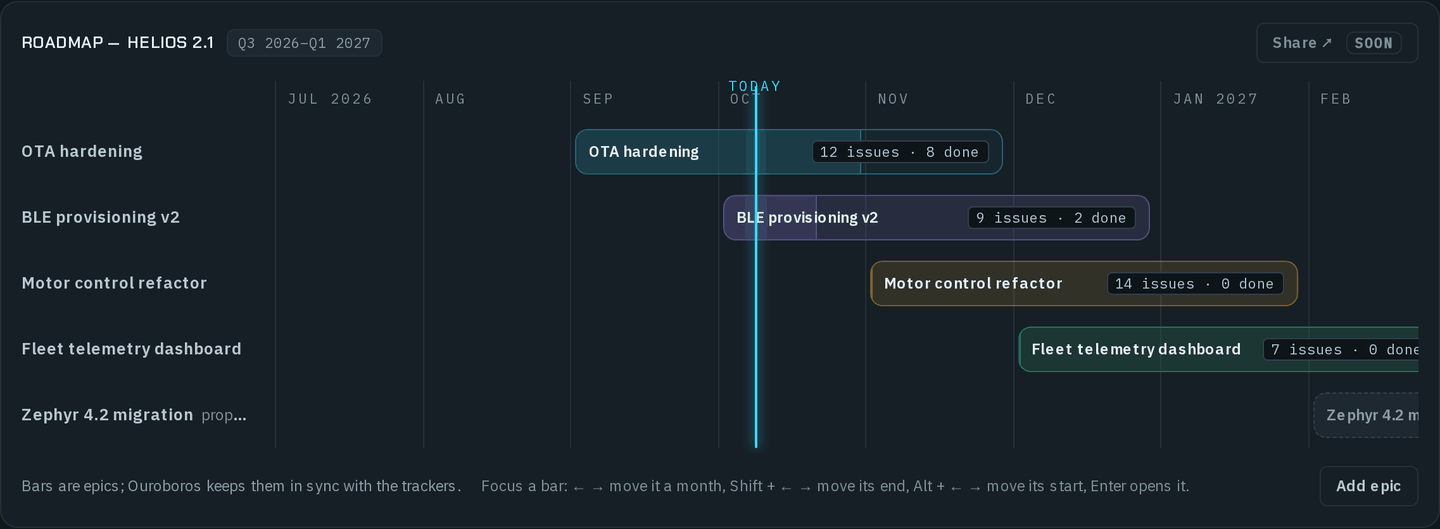

The roadmap
Your workspace has one roadmap, named after its epics — Roadmap — Helios 2.1, with its window, for example Q3 2026–Q1 2027, beside it. Each bar is an epic: a named piece of work across a range of months.
- The bar's chip counts the tickets linked to the epic and how many are done — 12 issues · 8 done — and the bar fills as they close.
- A dashed bar is unscoped: an epic with no months yet. proposed and done appear after an epic's name.
- TODAY marks today's date on the grid.
- The timeline shows epics only. Tickets and their dependencies are not drawn on it, and nothing on it is scheduled for you: each epic's months are the ones you set.
Creating a roadmap. New roadmap asks for a Roadmap name, an optional Window, the First epic, and optionally its First month and Last month — leave both empty for an unscoped epic. Create roadmap saves it. A workspace that already has a roadmap adds the new epic to it.
Changing the roadmap is for owners and admins:
- Drag a bar, or its ends, to change its months; the start, move and end arrows under it do the same a month at a time. With a bar focused, ← → move it a month, Shift + ← → move its end, Alt + ← → move its start, and Enter opens it. Each change is saved at once.
- Open a bar to edit its name, tint, status (Active, Proposed, Done or Unscoped) and months, and to Link or Unlink tickets. Only linked tickets count towards the chip.
- Add epic adds a lane at the bottom.
Others can open an epic to read it. Share ↗ and Import from Jira are marked soon and are not available yet.
What can go wrong
- "Connect a tracker to draft". No tracker is connected, so there is nothing to draft for. An owner or admin chooses Open settings and connects one — see Ticket sources & repositories.
- The milestone list does not load. Ouroboros could not read the tracker's milestones, usually because its token cannot be used. Choose No milestone, or ask an owner or admin to check the tracker's connection.
- "This batch's dependencies form a cycle (…), so no ticket of it can go first." Remove one of the links in the outline and draft a new batch.
- A row shows "failed — …". The reason names the step that failed, such as creating the ticket failed or linking a dependency failed. Fix the cause, then choose Resume push.
- "Every selected draft is already in GitHub." There is nothing left to push.
- "Select at least one draft to push." Tick at least one draft.
- A queued ticket is reported "not queued — not mirrored yet". The backlog has not mirrored the new issue yet. Queue it from Issues once it appears there and is sized.
